Most standard asphalt roof replacements in North Idaho take 1 to 3 days from tear-off to cleanup. A smaller ranch with a walkable pitch can wrap in a single day. A larger home, a steeper pitch, or a switch to metal or composite cedar shake stretches the timeline to 3 to 5 days. Weather is the biggest variable, and in North Idaho it pushes more jobs than any other factor.

We install across Hayden, Coeur d'Alene, Post Falls, Rathdrum, Sandpoint, and the rest of our North Idaho service area. The timeline below is what we actually see on the job, not the marketing version. We will also tell you what to plan for at home: pets, parking, kids, things falling off the walls inside.

The Short Answer: 1 to 3 Days for Most North Idaho Homes

Here is the quick version, scoped to the kinds of homes we replace roofs on every week in North Idaho.

  • Single-family asphalt, walkable pitch, 1,800 to 2,400 square feet of roof area: 1 to 2 days.
  • Larger home (3,000+ sq ft roof area) or steeper pitch: 2 to 3 days.
  • Metal standing seam: 3 to 5 days. Panel runs, custom flashing, and slower per-square install all add time.
  • Composite cedar shake (Brava): 3 to 5 days. Heavier material and tighter exposure means slower install.

Two-story homes do not usually take longer than one-story homes with the same square footage. The extra setup and teardown is real, but it does not move the timeline much on its own. What actually slows a job down is pitch, complexity (skylights, chimneys, dormers, multiple roof planes), and whatever the sky decides to do that week.

Day-by-Day Timeline of a Roof Replacement

Here is what an actual replacement looks like, broken into the phases you will see on your house.

Before Day One: Inspection, Measurement, and Material Selection

This part happens 2 to 6 weeks before the crew shows up.

  • Inspection (30 to 60 minutes). We walk the roof, look at the underlayment edges, flashing, ventilation, and the attic if accessible. We document existing damage with photos. This is also when we flag anything that will affect timeline, like decking that is likely soft or a chimney that needs new flashing regardless.
  • Satellite measurement and estimate. You can get a ballpark in about a minute through our satellite roof calculator. The in-person inspection produces the final, exact number.
  • Material selection. Asphalt is the fastest install. Metal and composite take longer. We walk through tradeoffs in our materials comparison and break it down further in shingles vs metal.
  • Permits. Pulled by us where required. Hayden, Coeur d'Alene, and Post Falls each have slightly different requirements. Most permits issue within a few business days.
  • Material delivery. We schedule the material delivery based on the size of your home and the permit process, so the shingles, underlayment, and ice and water shield are on site when the crew is ready to start.

Day One: Tear-Off and Dry-In

This is the loudest, dustiest day. Plan accordingly.

  • Site protection. Tarps go over landscaping and AC units. Plywood protects HVAC condensers and any glass features near the eaves. Plants close to the house get wrapped.
  • Tear-off. Old shingles, underlayment, drip edge, and pipe boots come off. A dump trailer in the driveway takes the debris straight off the roof.
  • Decking inspection. Once the roof is bare, we check every sheet of plywood for rot or sponginess. Damaged decking gets replaced before anything else goes back on. This is also the only point where the price can move on a fixed bid, and only if hidden rot is found.
  • Drip edge, ice and water shield, and synthetic underlayment. Our standard install puts ice and water shield 2 feet up from the eaves, in every valley, and around every penetration. Synthetic underlayment goes over the rest of the deck.
  • Dry-in. The roof is fully watertight before the crew leaves for the day, regardless of how far the install got. If rain is in the forecast overnight, dry-in is the priority.

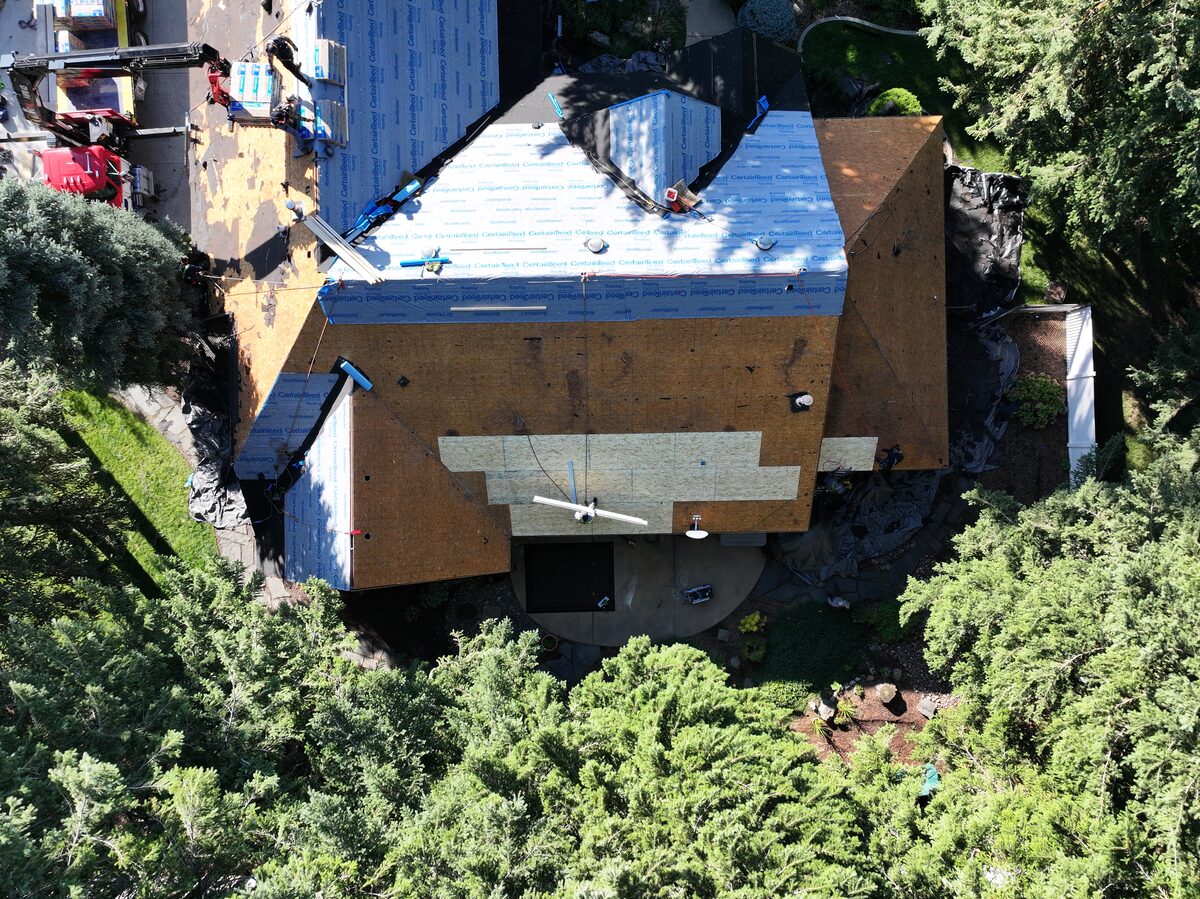

Tear-off in progress on a North Idaho roof replacement, with old shingles removed and the deck exposed

Tear-off in progress. Once the deck is bare, every sheet of plywood gets inspected before anything new goes back on.

Day Two: Underlayment, Flashing, and Shingle Install

On a typical North Idaho asphalt job, this is where most of the visible work happens.

  • Starter strip along the eaves and rakes.
  • Step flashing where the roof meets walls. Counter-flashing into chimneys.
  • New pipe boots on every penetration. Old ones leak first, so this is not a place to save twenty bucks.
  • Shingles installed in courses up the roof, matched per the manufacturer's nailing pattern (6 nails per shingle is standard for our wind region, not 4).
  • Ridge vent installed along the ridge, capped with ridge shingles.

On a smaller home, the crew can finish shingle install by mid-day two. On a larger or steeper roof, install runs into day three.

Day Three: Cleanup and Final Walkthrough

  • Magnet sweep (twice). We run rolling magnets across the lawn, driveway, and surrounding property to pick up nails. Twice, not once. Then a hand pass anywhere kids or pets go.
  • Trash trailer hauled off. Debris leaves the property the same day, not "sometime next week."
  • Final walkthrough. We walk the property with you, point out the new flashing, ridge vent, and any decking we replaced. We answer questions. We hand off the workmanship warranty paperwork in writing.
  • Manufacturer warranty registration. Photos and the install record get filed with the shingle manufacturer to register your enhanced warranty (if applicable to your install tier).

Weather drives the schedule. We monitor the forecast closely and time tear-off and install around it. If the weather is not right, we wait. We will not open up your roof on a day the sky is going to fight us.

What Slows a Roof Replacement Down?

Most of the timeline variance comes from a short list of factors.

  • Pitch. A 4/12 pitch is walkable. A 10/12 pitch needs roof jacks, harnesses, and slower work. Steep roofs can add a full day.
  • Square footage and number of roof planes. A single rectangle is fast. A roof with five planes, two dormers, and three valleys is slow no matter how good the crew is.
  • Skylights, chimneys, and penetrations. Each one needs its own flashing detail. More penetrations means more time.
  • Material choice. Asphalt is the fastest. Metal and composite are slower because of panel runs, custom cuts, and tighter tolerances.
  • Hidden decking damage. Found at tear-off. Replacing rotted plywood adds half a day to a full day. We will not cover rotted decking, even if the bid was tight, because the warranty depends on it.
  • Permit timing. Most jurisdictions issue same week, but Sandpoint and the unincorporated county areas occasionally take longer.

How North Idaho Weather Changes the Timeline

This is the part most contractors gloss over and homeowners feel.

  • Spring (March to May). Wet. Expect rain delays, especially closer to Sandpoint and the lake. Build a 1 to 2 day buffer into your schedule.
  • Summer (June to August). Best install window. Long daylight, low chance of rain, warm enough for shingle seal strips to activate fully.
  • Fall (September to mid-November). Excellent. Dry, cool, and the install calendar fills up because every homeowner who put it off in spring is trying to get in before winter.
  • Winter (mid-November to February). We will not install a roof below 40°F unless we are installing CertainTeed ClimateFlex. ClimateFlex is the only shingle in the CertainTeed lineup rated for installation in cold weather, because the polymer-modified asphalt stays flexible and seals properly when standard shingles will not. For any other shingle, the seal strips do not activate in the cold, which voids the manufacturer warranty. Emergency repairs continue year-round. Standard replacements wait for spring.
  • Wind. We do not tear off in sustained winds over about 25 mph. Loose shingles become projectiles, and dry-in becomes unsafe.

If your replacement is tied to an insurance claim after a wind event, the timeline also depends on how fast the adjuster signs off on scope. We coordinate that directly with the carrier so the install window is not stuck waiting.

Want a ballpark number for your specific roof before you start scheduling? Our satellite calculator pulls measurements from your address and gives you a price range in about a minute.

Get My Estimate

What Should You Plan For During the Job?

The roof itself is on us. The household is on you, and a little planning makes the days easier on everyone.

  • Pets. The noise is intense. Hammers, nail guns, and crew on the roof. Dogs that bark at the doorbell will not be okay with this. Plan to have them inside on the far side of the house, or off-site for tear-off day.
  • Cars. Move them out of the driveway and at least one house down the street. Nails and debris will land in the driveway, even with tarps, and the dump trailer needs the space.
  • Kids and napping. The noise is constant. Schoolwork or naps at home are tough. Mid-day quiet windows do not exist on tear-off day.
  • Things on walls. The vibration travels. Picture frames, light fixtures with loose screws, and shelving on plaster walls can shift. Take down anything fragile that hangs from a single nail.
  • Power and water. Not disrupted. You can work from home, shower, and cook normally. The job is exterior only.
  • Crew bathroom and food. We do not need access to your house. We bring our own supplies.

Frequently Asked Questions

How long does a roof replacement take on average?

Most single-family asphalt roof replacements in North Idaho take 1 to 3 days from tear-off to cleanup. A small ranch with a walkable pitch can wrap in a single day. Larger homes, steeper pitches, or a switch to metal or composite cedar shake stretch the timeline to 3 to 5 days.

Can a roof be replaced in one day?

Yes. A smaller asphalt roof, 1,800 to 2,400 square feet of roof area with a walkable pitch, can be fully torn off, dried in, and installed in one day with a full crew. Cleanup and the final magnet sweep often spill into the morning of day two.

Do I need to leave the house during a roof replacement?

No. You can stay in the house during a full replacement. It is loud, and small items on shelves can vibrate, but utilities are not disrupted. Most homeowners stay home. Pets and people who nap or work calls from home are usually happier off-site for the tear-off day.

What happens if it rains during my roof replacement?

The crew dries the roof in completely before leaving the job site. Synthetic underlayment and ice and water shield are watertight on their own, so a covered roof is protected through rain or overnight weather. If a heavy storm is forecasted during install, we pause tear-off and reschedule the open portion rather than risk water getting into the deck.

How far in advance should I schedule a roof replacement?

Two to six weeks is typical in North Idaho during the install season. Spring and late fall fill up the fastest because everyone is trying to beat the weather. Insurance claim jobs sometimes get on the calendar faster because materials and scope are pre-approved by the adjuster.

The Honest Version

We are a newer company in North Idaho, still building our name in Hayden and Coeur d'Alene. That means a few things. We work weekends if it gets the job done before weather rolls in. We give you the same straight answer on timeline that we would give our own family, even if it costs us the booking. And if we tell you 1 to 3 days, we mean it. If something pushes that, you will hear from us the same morning, not at the end of the week.

If you are ready for a real number on your specific roof, start with the satellite calculator for a 60-second ballpark, or schedule a free in-person inspection for an exact estimate and a date on the calendar.

Ready to Get on the Schedule?

Get a ballpark in 60 seconds with the satellite calculator, or book a free in-person inspection for an exact estimate and a date on the calendar.

Schedule My Inspection
